For Suppliers

Cybersecurity Information

Covered Defense Information, Including Controlled Unclassified Information

On October 21, 2016, the Department of War (DOW) published the final rule for Defense Federal Acquisition Regulation Supplement (DFARS) 252.204-7012, “Safeguarding Covered Defense Information and Cyber Incident Reporting.” This represents DOW’s ongoing efforts to prevent improper access to important unclassified information. As a result, contractors must provide security for “covered contractor information systems,” to include implementing the security controls of National Institute of Standards and Technology (NIST) SP 800-171. A covered contractor information system is an unclassified information system that is owned or operated by or for a contractor and that also processes, stores, or transmits covered defense information (CDI).

APL’s Annual Representations and Certifications includes questions about your company’s ability to handle CDI, such as Controlled Unclassified Information (CUI), in compliance with the cyber DFARS clause 252.204-7012. We recommend that you check with your IT security professionals and legal counsel during the certification process.

It is our policy to only share CDI with suppliers who have assured us that they are capable of handling it. In particular, DFARS 252.204-7019 requires that contractors perform self-assessments that are submitted to the Supplier Performance Risk System (SPRS) before working with CUI. DFARS 252.204-7020 also requires that suppliers be verified.

The applicable flow-down clauses are included in APL’s terms and conditions for its partner suppliers. The DFARS clauses are required to be flowed down in any subcontracts or similar contractual agreements in which subcontract performance will involve CDI, including CUI. This clause must be flowed down without modification. We appreciate your partnership to minimize risk and safeguard our sensitive information.

Cybersecurity Maturity Model Certification

In 2025, the Department of War (DOW) finalized its Cybersecurity Maturity Model Certification (CMMC) program. Industry experts estimate it can take 12–18 months to prepare for CMMC certification. CMMC compliance is now a requirement at the time of contract award. The full details of the requirements, including the phased implementation plan stating when the requirements apply, are defined in DFARS clause 252.204-7021. APL recommends that our partners become familiar with CMMC requirements and work to meet the requirements.

CMMC is a DOW program that confirms that organizations have implemented existing security requirements to protect Federal Contract Information (FCI) and Controlled Unclassified Information (CUI). As DFARS 252.204-7021 is final and in effect, all DOW contractors and subcontractors, except companies that are solely providing commercial off-the-shelf (COTS) items, must achieve compliance with CMMC requirements to be eligible for contract award. Suppliers are now responsible for ensuring their organization can meet all of the cybersecurity requirements. When CUI is required as part of the contract, a CMMC certification assessment requires suppliers to source an official CMMC Third-Party Assessment Organization (C3PAO) who will conduct a formal assessment and report the results to DOW. At CMMC Level 3, a DOW assessment is also required.

CMMC Levels

As stated above, it is estimated that it may take 12–18 months to prepare for CMMC certification. We recommend that all suppliers prepare now to ensure readiness to meet CMMC requirements in advance of new contract awards based on the CMMC phased implementation schedule.

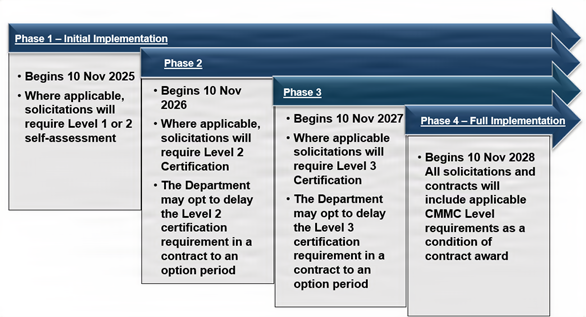

CMMC phased implementation schedule
DOW may implement CMMC Level 2 (C3PAO) requirements in some Phase 1 procurements or Level 3 requirements in some Phase 2 procurements, which may limit competitors or drive cost.

Source: Department of War Chief Information Officer

As of July 13, 2026, CMMC is undergoing a strategic review at the request of the Hon. Kristen Davies, DOW CIO. During this time, the requirement for mandatory certification assessments (Level 2 – C3PAO) is suspended. CMMC Level 1 and Level 2 – Self are still in place.

Learn more about the complete details regarding CMMC and the existing regulations using the following resources.
